Case Study | Multi-Site Workplace Consolidation


+ A Move with Construction Behind It
Two Sites. One Coordinated Workplace Reset.
ASI connected origin decommissioning, a physical move, furniture reuse, electrical alterations and technology reconnection in one managed San Diego consolidation.
Overview
Challenge
Consolidating two workplaces required more than moving furniture. The destination needed existing stations removed, walls opened and circuits relocated to receive reused workstations. Origin disconnections, transport, installation and technology reset had to follow the same coordinated sequence.
ASI Approach
ASI managed the crews and subcontractors across Scripps Ranch and Camino Del Rio. The team linked destination preparation, electrical and low-voltage pathways, origin teardown, asset transfer, furniture installation and computer reconnection to the approved layout.
Results
- Existing workplace assets redeployed to the destination
- Electrical alterations and wall repairs coordinated with the move
- Workstations rebuilt and technology reconnected
U.S. Bank | San Diego
The furniture move depended on construction that was not visible in the final workplace. ASI managed both: opening and repairing walls, relocating circuits and preparing pathways while coordinating the transfer, rebuild and technology reset across two sites.
Project Info
- Client
- U.S. Bank
- Location
- San Diego, California
- Origin
- Scripps Ranch
- Destination
- Camino Del Rio
- Delivery
- Managed multi-trade
- Status
- Completed phase
Plans and Trade Interfaces

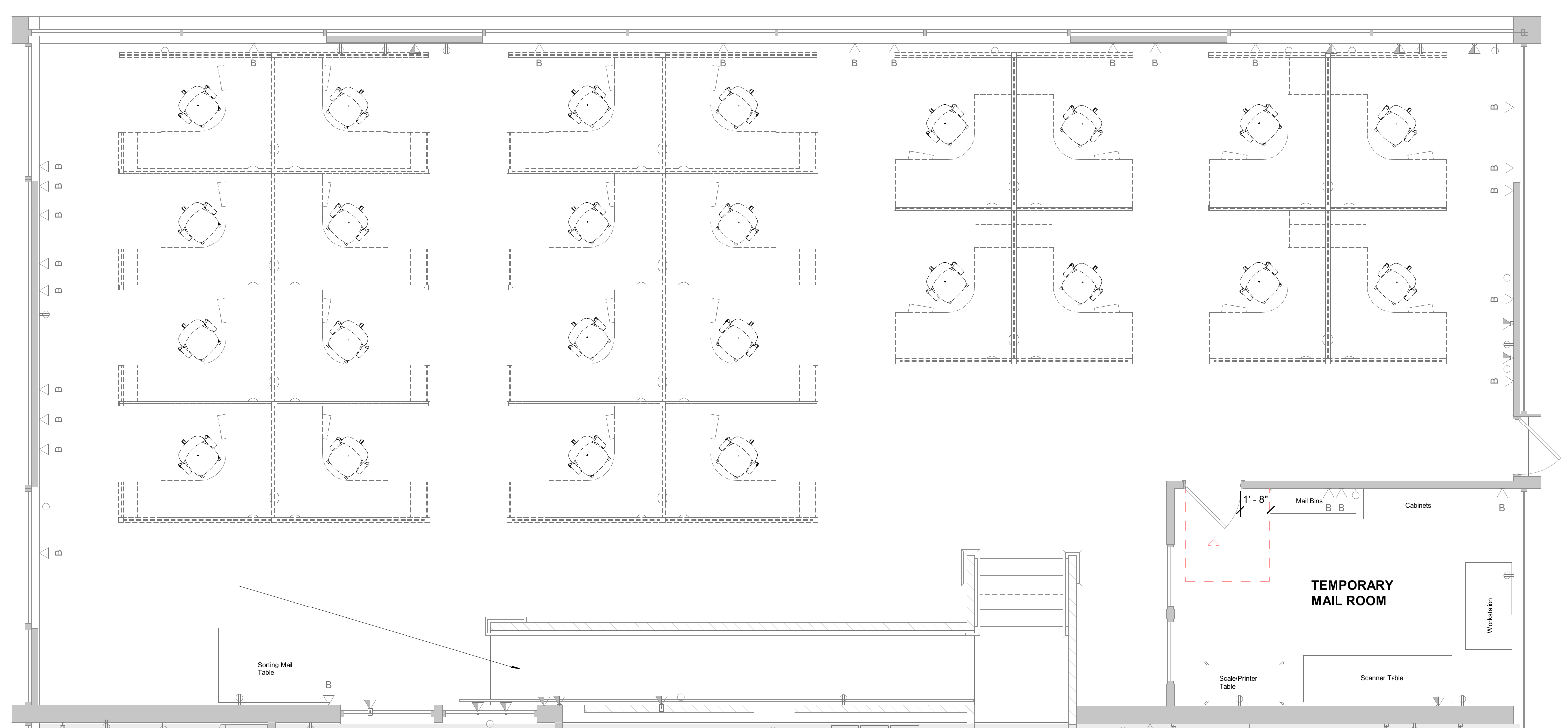

The Layout Set the Destination. ASI Connected the Work Behind It.

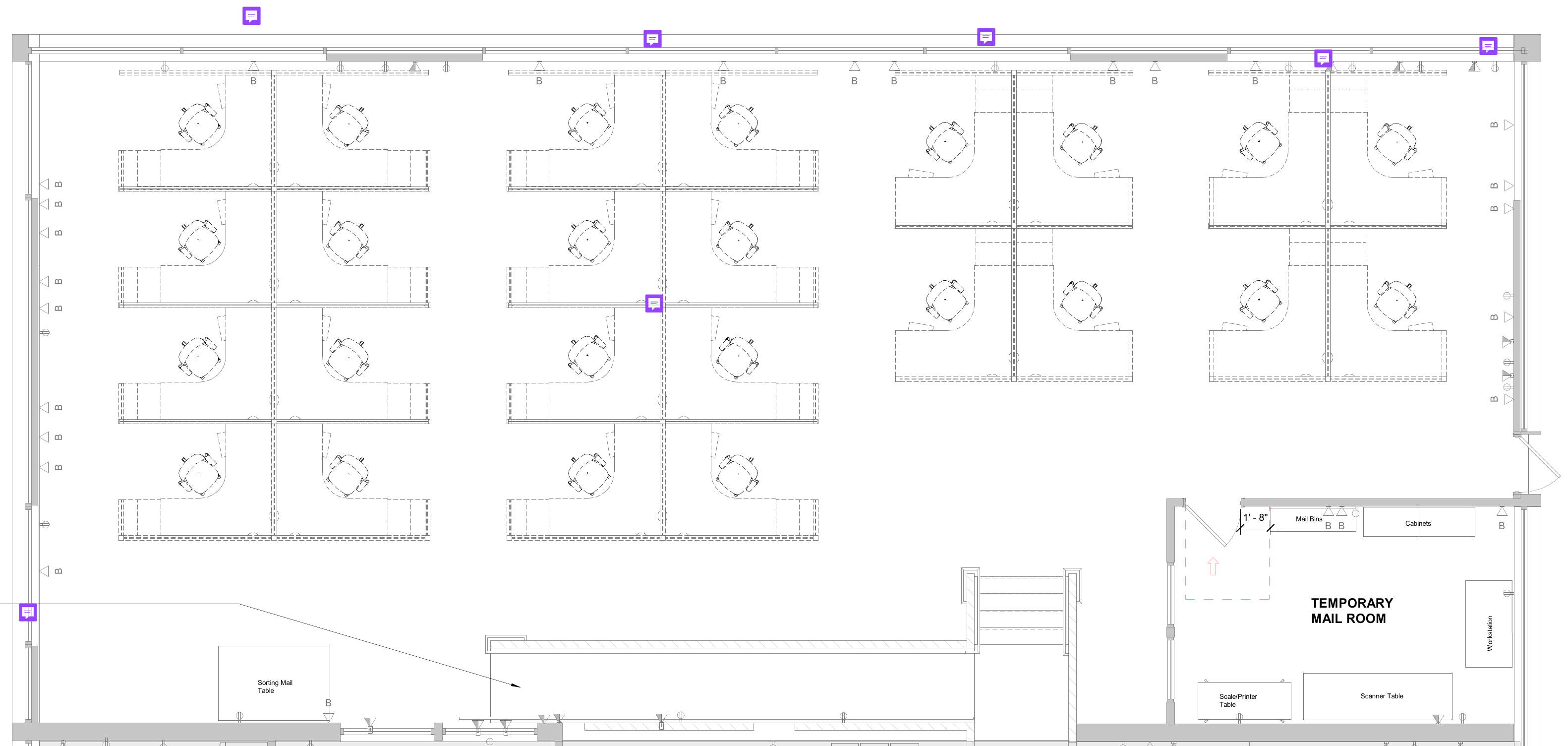

The furniture arrangement guided the consolidation. The existing-power markup identified interfaces that had to be addressed alongside destination demolition, circuit relocation and workstation installation. These are coordination views, not as-built drawings.


Construction and the Move Had to Advance Together
Destination preparation, circuit relocation, workstation reuse and technology reset were connected to one sequence across Scripps Ranch and Camino Del Rio.
The ASI Delivery Model
Construction and the Move Had to Advance Together.
ASI managed the field team and specialist subcontractors around a shared delivery plan. Each handoff prepared the next trade, asset movement or technology connection.
Prepare the Destination
Remove designated existing stations at Camino Del Rio. Protect the building and align access, material handling and the incoming furniture arrangement.
Rework the Infrastructure

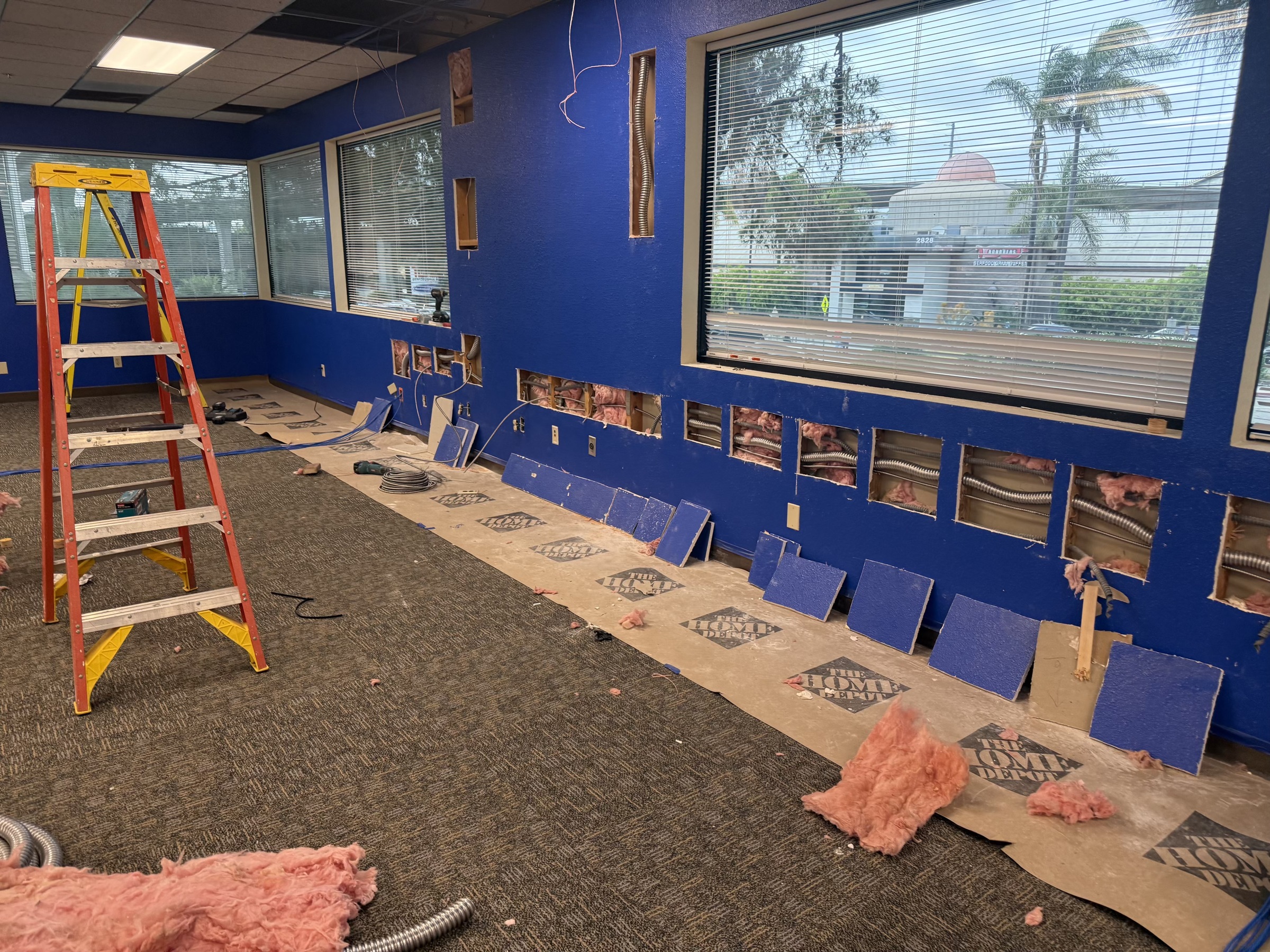

Open walls, relocate electrical circuits and prepare low-voltage pathways. Coordinate drywall and paint repairs with the electrical work and furniture sequence.
Decommission and Transfer
Teardown designated stations at Scripps Ranch, coordinate electrical disconnections and transport the retained assets to Camino Del Rio for reuse.
Rebuild and Reconnect

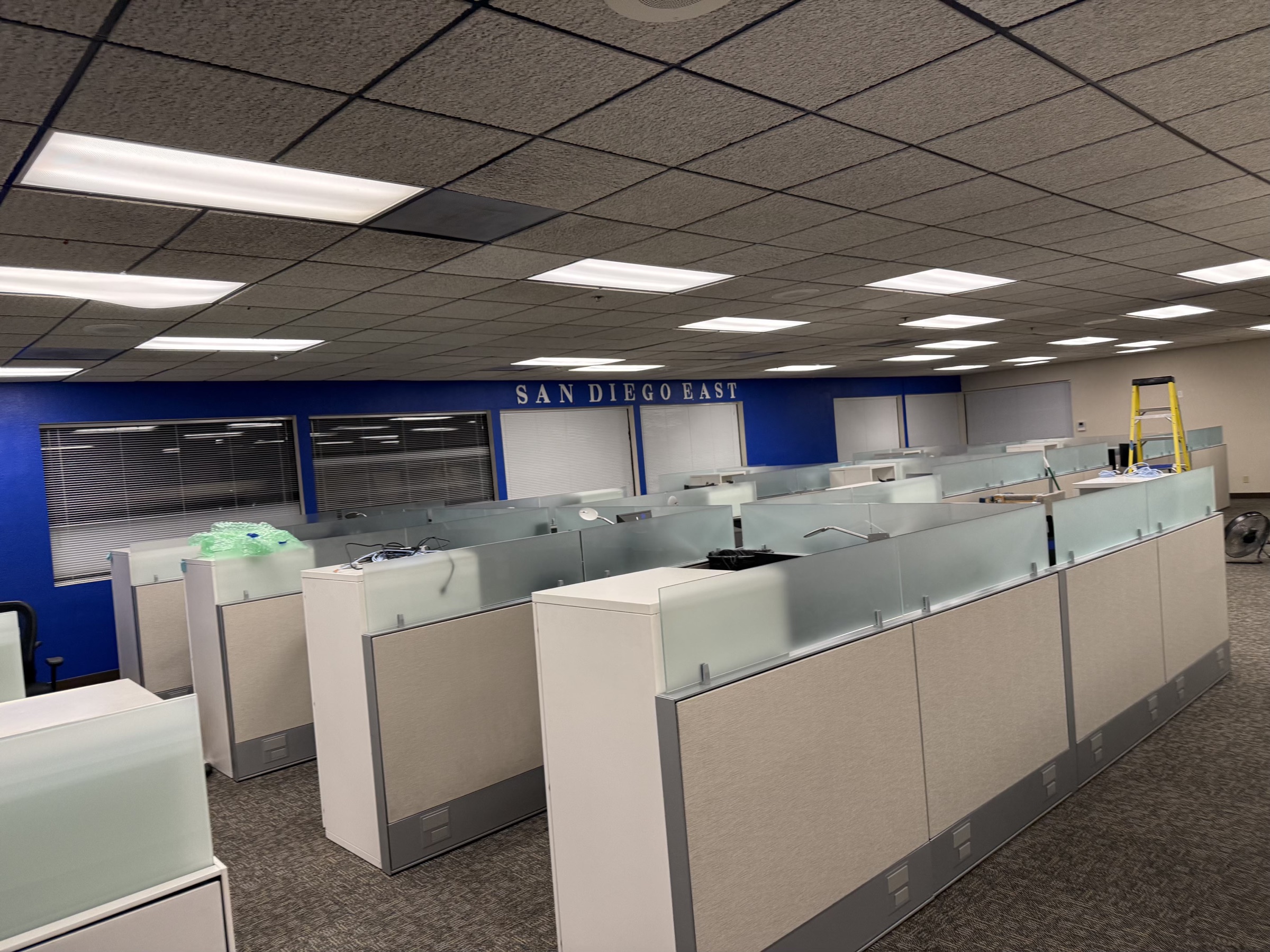

Reinstall workstations to the plan. Match labeled PCs and peripherals to their stations, reconnect equipment and perform power-on and basic functionality checks.
Manage the Field Handoffs
Coordinate ASI crews, the installation subcontractor and electrical work. Resolve changing requirements and document the completed consolidation phase.
One Team Controlled Every Dependency
Destination preparation had to receive the incoming assets. Origin teardown and transport then fed the installation sequence, with circuits, pathways and technology connections coordinated around the final station positions.
One accountable plan across both workplaces.
The Outcome
Reused Assets. Rebuilt Workstations. The Infrastructure to Support Them.
The completed consolidation phase brought retained furniture into the destination workplace and connected it to the electrical alterations, pathways and technology reset needed for the new arrangement.
Origin and destination work managed within the same program.
Retained workstations transferred and rebuilt to the destination plan.
Wall repairs, circuit changes and technology handoffs coordinated.
What the Project Delivered
Origin and Destination Linked
Designated Scripps Ranch furniture was dismantled and transferred while Camino Del Rio was prepared for the incoming arrangement.
Construction Supported the Layout
Wall openings, circuit relocations, low-voltage pathways and repairs were managed as part of the furniture transition.
Technology Followed the Users
Workstation equipment was identified, staged, moved and reconnected at the destination with basic functionality checks.
Delivery Stayed Accountable
ASI managed its field crews and subcontractors through the completed phase, including changing scope and coordinated closeout records.
One Accountable Partner. Construction, Asset Reuse and Workplace Transition.
For a real estate team, the value is one partner connecting the scopes that otherwise fall between a mover, furniture installer, electrician and technology team. ASI managed those interfaces across both locations.
Planning a Complex Workplace Consolidation?

Project Details

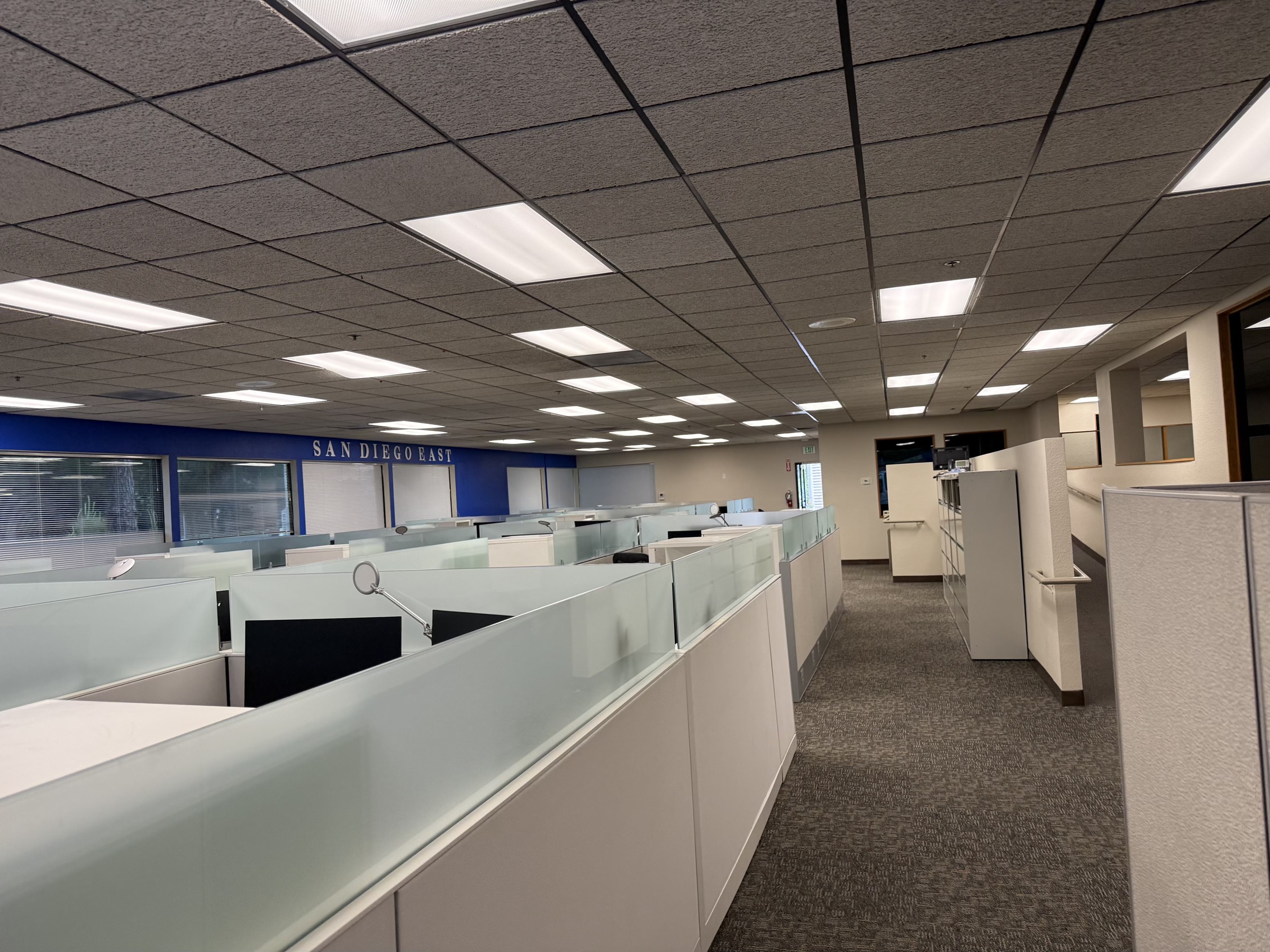

The Work Behind the Walls. The Workplace It Made Possible.
Circuit-relocation openings at Camino Del Rio led into the rebuilt workstation area. The completed phase joined construction, furniture reuse and technology reset in the same workplace.




One Accountable Partner Across Both Workplaces.
ASI connected destination construction, origin teardown, asset reuse, electrical work and technology reset through one managed consolidation phase.
